Auckland Council requirements, building consent timelines, and the planning steps to get right before you swing a hammer. Cut through the red tape with clear, practical guidance.
32 Guides Updated 2026
Articles & Project Stories
Planning & consent guides
Consent and planning is where most Auckland renovations slow down. The guides below cover what needs consent, what doesn’t, how long it really takes, and how to keep your project moving through council.
Do You Need Building Consent to Renovate a Bathroom or Kitchen in NZ? (2026)
By Simon Liu · Founder, Add Value RenovationsRegistered Master Builder · Licensed Building Practitioner · House of the Year Gold winner 2025 and 2026 · 500+ Auckland renovationsUpdated 11 Nov 2026 · 8 min read
Most bathroom and kitchen renovations in an existing New Zealand house need no building consent, as long as you are replacing or moving fittings you already have. You need consent when you add a bathroom, toilet, basin or shower that was not there before, or when you remove a load-bearing wall.
“I was trying to understand what triggers consent. It’s hard to get an answer.” We hear that in about half of our consultations. The rules are set out in Schedule 1 of the Building Act, and they are more generous than most people expect. This guide goes through the common jobs one by one, using the Ministry of Business, Innovation and Employment’s current guidance (January 2026) and Auckland Council’s own advice.
Remuera ensuite, 2026. An existing ensuite stripped out and rebuilt in the same room. Same fixtures, same room: this kind of renovation usually needs no building consent.
The rule in one line
Same number of fixtures in the same house: usually no consent. One more fixture, or a structural change: consent.
A fixture here means a toilet, basin, bath, shower, sink or laundry tub. You can replace them, and in most cases move them, without a building consent, provided a licensed plumber does the plumbing. The moment you add one that was not there before, you need consent.
Bathroom jobs, one by one
Job
Consent?
Why
Replace a vanity, toilet, bath or shower in the same place
No
Replacing an existing fixture
Move the vanity, toilet, bath or shower within the same bathroom
No
Repositioning existing fixtures in an existing bathroom
Move the toilet from a separate toilet room into the bathroom next door
No
Still the same number of fixtures
Swap a shower-over-bath for a separate shower and a new bath
No
Two fixtures before, two after
Replace an acrylic shower with a tiled shower
Usually no
Linings and finishes in an existing dwelling
Retile the walls or floor, new waterproofing underneath
No
Linings and finishes in an existing dwelling
Reline walls and ceiling with new plasterboard
No
Linings in an existing dwelling
Level-entry shower that needs the floor joists cut down
May need it
The work affects the floor structure
Add a basin to a separate toilet room
Yes
An extra fixture
Add a second toilet
Yes
An extra fixture
Add a new ensuite or a second bathroom
Yes
Extra fixtures and new drainage
Any bathroom move in an apartment that goes through a fire-rated wall or floor
New cabinets, benchtop and splashback in the same layout
No
Remodelling within the same space
Move the sink to another wall
Usually no
Altering existing plumbing with no extra fixture
Swap a gas hob for induction
No building consent
Electrical work, certified by a licensed electrician
Remove a timber-framed wall that is not load-bearing, not a bracing wall and not a fire wall
No
Internal walls in an existing building
Remove or alter an internal brick, block or concrete wall
Yes
Masonry walls are excluded from the internal wall exemption
Remove a load-bearing or bracing wall to open the kitchen up
Yes

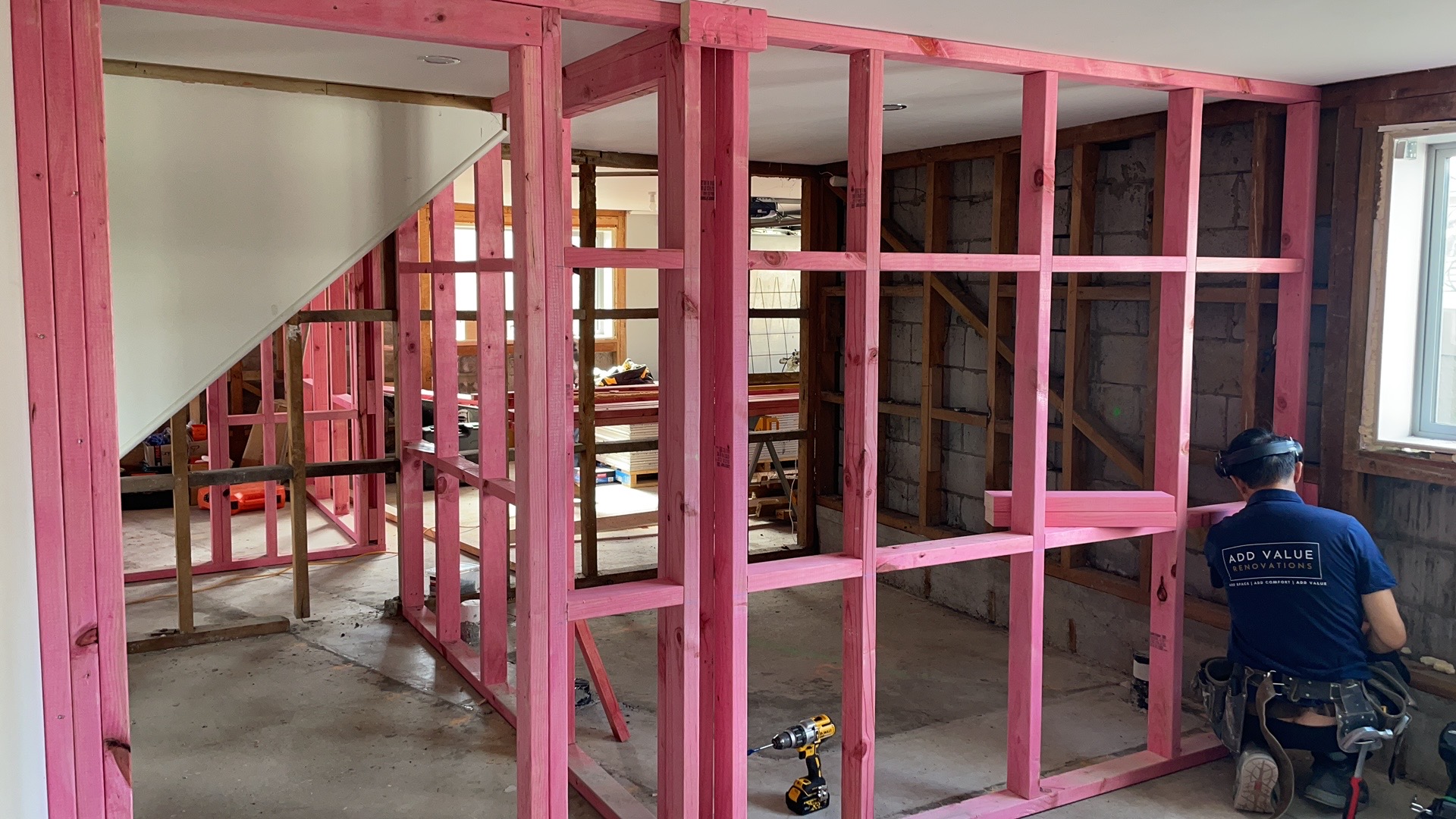

Structural work, with an engineer’s design
Add a second kitchen or kitchenette
Yes, and check planning rules
An extra sink, and it may count as a second dwelling

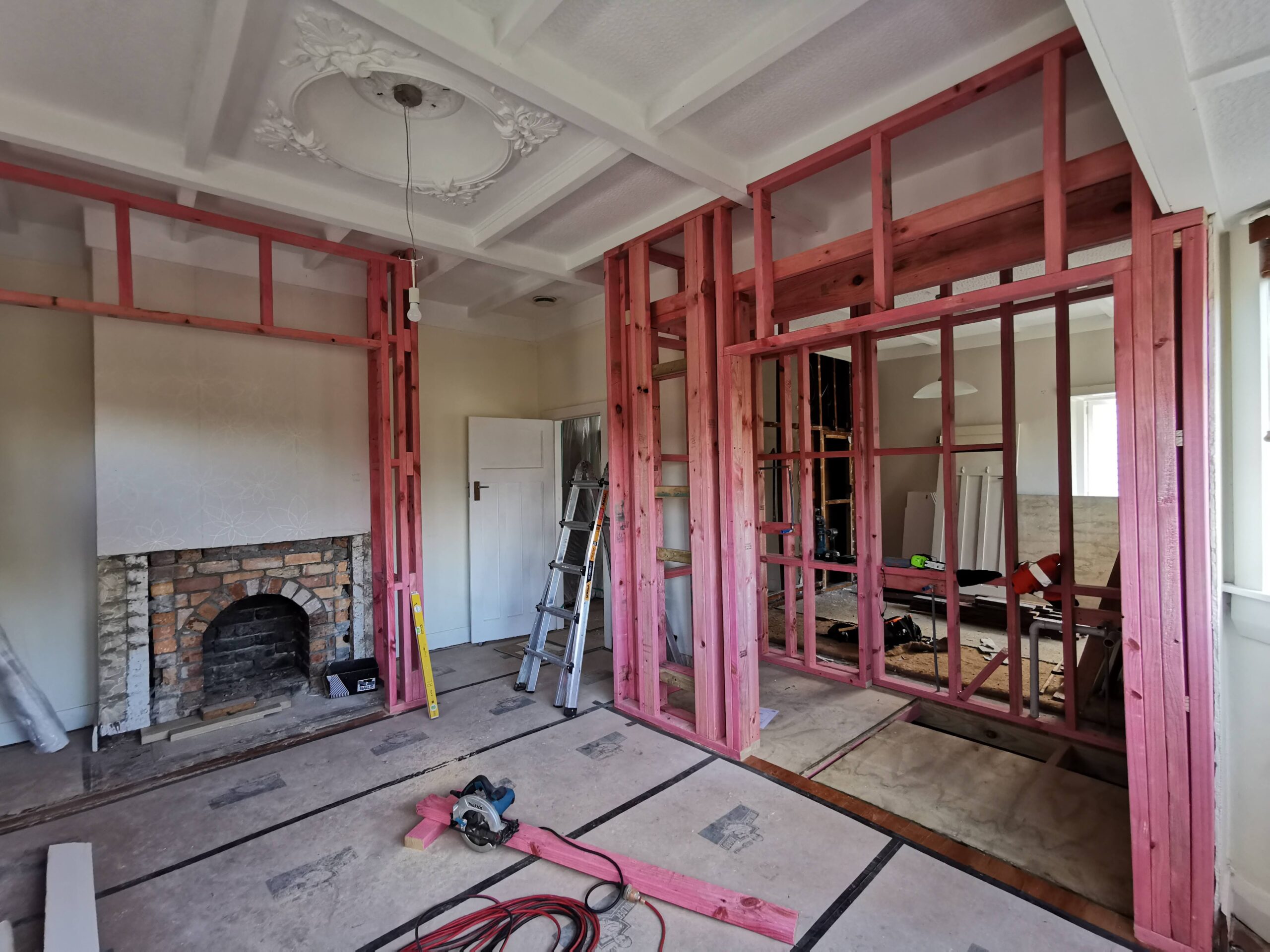

The wall is where most kitchen renovations meet the council. If you are opening a kitchen to the living room, find out early whether the wall carries load or braces the house. Our wall removal guide explains how we check, and what load-bearing wall removal involves.
Hillsborough, 2026. This kitchen was part of an extension, so the whole project went through building consent. A kitchen refitted inside its existing room would not have needed it.
The tiled shower question
For years the common advice, including ours, was that a tiled shower often needed building consent because of the waterproof membrane under the tiles. MBIE’s guidance changed in October 2025, and in an existing house, replacing a shower or bath with a tiled shower in the same bathroom usually needs no consent. It still does if the shower is part of a new ensuite, the floor structure is cut down for a level entry, or a bracing wall loses its bracing lining.
Our tiled shower consent guide sets out the sources, what MBIE and Auckland Council told us, and how to get it in writing for your job.
If a quote includes consent for a bathroom, ask why
There are good reasons: a new ensuite, a structural change, an apartment. If the only reason given is “because the shower is tiled”, the quote is working from the old rule and you may be paying about $5,000–$7,000 and waiting weeks for something the job does not need.
What consent costs and how long it takes
When a bathroom or ensuite does need building consent, allow about $5,000–$7,000 for the drawings and Auckland Council’s fees. Structural kitchen work is similar, plus the engineer’s design.
The council has 20 working days by law to process an application, and the clock stops each time it asks for more information. Add the time to prepare the drawings before that. The council also inspects the work at set stages, and issues a Code Compliance Certificate at the end.
The work must meet the Building Code. Exempt means you do not apply to the council. It does not lower the standard.
Plumbing and drainage must be done by a licensed plumber or drainlayer. If it is not, the exemption does not apply.
Electrical work needs a licensed electrician and a certificate of compliance.
Waterproofing should be done by a trained installer who gives you a written record of the product and the areas covered.
Keep the paperwork. Photos before the linings go on, the plumber’s and electrician’s certificates and the waterproofing record. A buyer’s lawyer will ask for them one day.
For exempt work, the owner and their Licensed Building Practitioner decide whether the job fits the exemption, and should write down why. If you want certainty from the council for your particular job, you can apply for an exemption under clause 2 of Schedule 1, or apply for consent.
What if work was done without consent?
We often meet this in houses that have just changed hands: a downstairs bathroom or a moved kitchen that never went through the council. You cannot get a building consent for work that is already finished. The council can issue a Certificate of Acceptance for work it is able to inspect, and anything it cannot verify may have to be opened up. If you are renovating anyway, that is the cheapest time to put it right. Our Remuera garage conversion project shows a downstairs space being made legal.
Do I need building consent to renovate a bathroom in NZ?
Usually not, if you are replacing or moving the fixtures already in that bathroom and a licensed plumber does the plumbing. You need consent to add a toilet, basin, bath or shower that was not there before, or to change the structure.
Do I need consent to move a toilet?
Not when it moves within the same bathroom, or from a separate toilet room into the bathroom next to it. The plumbing must be done by a licensed plumber. In an apartment, check first whether the pipes pass through a fire-rated floor or wall.
Do I need consent to change a bath to a shower?
Usually not. Replacing one existing fixture with another in the same bathroom is normally exempt, including replacing a bath with a tiled shower, provided no fixture is added and the floor structure is not altered.
Do I need consent to retile a bathroom?
No. Tiles, waterproofing and wall linings in an existing house are covered by the exemption for internal linings and finishes. The waterproofing must still meet the Building Code.
Do I need consent to renovate a kitchen?
Not for new cabinets, benchtops and appliances in the same room. Moving the sink usually needs no consent either. Removing a load-bearing or bracing wall does, and so does adding a second kitchen.
How much does building consent cost for a bathroom in Auckland?
About $5,000–$7,000 for the drawings and council fees when a bathroom or ensuite needs it. A like-for-like bathroom renovation normally does not.
How long does building consent take in Auckland?
The council has 20 working days to process it, not counting time spent waiting on questions. Allow extra time for the drawings to be prepared first.
Who applies for the consent, me or the builder?
The owner is the applicant, but your designer or builder normally prepares and lodges it for you. On our jobs we handle the drawings, the application, the inspections and the final certificate.
Not sure if your renovation needs consent?
Tell us what you are planning and we will tell you where it stands, before you pay for drawings.
Written by Simon LiuFounder, Add Value Renovations · Registered Master Builder · LBP · House of the Year Gold winner 2025 and 2026Add Value Renovations is an Auckland design-and-build company specialising in kitchen, bathroom, full home, and extension renovations. Master Builder 10-year guarantee, $2M public liability insurance, and a track record of 500+ Auckland renovations since 2014.
Building Inspection, Price Check or Builder’s Site Visit: Which Do You Need Before You Buy?
By Simon Liu · Founder, Add Value RenovationsRegistered Master Builder · Licensed Building Practitioner · House of the Year Gold winner 2025 and 2026 · 500+ Auckland renovationsUpdated 10 Nov 2026 · 8 min read
Get the building inspection first, because it finds the problems. A price check then puts a cost range on each item, and a builder’s site visit is for a house where the numbers are big or the report is unclear. Most buyers need the first two.
If you are buying your first house, or your first older one, it is hard to know which checks exist, who does them and what order they go in. This guide sets the three side by side. One thing to say up front: we are builders, not building inspectors. We do not carry out building inspections and nothing we sell replaces one. What we do is put prices on what the inspector found.
A weatherboard villa from one of our published projects. The photo shows a finished job of ours, not a house with problems.
The short answer
Building inspection
Building Report Price Check
Builder’s site visit
What it is
An inspection of the house and a written report on its condition
A desktop study that prices every item in your building report
A builder walks the house with your report in hand
Who does it
An independent property inspector you hire. Not us
Our Master Builder with our quantity surveyor (QS)
Our building team
What you get
A list of defects and the maintenance the house needs
A low–high price range for each item, marked urgent, soon or cosmetic
Up to 1 hour on site, then a written price update
Cost
Set by the inspector. Ask for a quote
$199 Standard, $299 Next working day
$449, or $250 if you already bought a Price Check on that house
Time
Ask the inspector when you book
2 working days, or the next working day
Price update within 2 working days of the visit
Does it need a report first?
No. This is the report
Yes
Yes
Already have your inspection report?Get every item in it priced as a low–high range, $199.See the Price Check →
Our service prices include GST. We have left the inspection’s cost and timing in words on purpose: inspectors set their own fees and bookings, and we will not guess a figure for someone else’s service.
What a building inspection does and does not do
The inspection is the base everything else stands on. Settled.govt.nz, the government’s home-buying guide, says that before you buy you need to check the land and buildings to identify any significant defects and to understand what urgent or future maintenance is needed. Its advice is to hire an accredited property inspector and ask for a report that meets the New Zealand building inspection standard, NZS 4306:2005.
The same page makes four points worth knowing before you book:
There is no licensing regime for inspectors in New Zealand. Settled lists professional bodies that register and accredit their members, which is the practical way to find a qualified one.
Check the insurance. Settled says to make sure the inspector has a good level of indemnity insurance, so you are covered if something that should have been found is missed.
Commission your own report. If you rely on a report the seller or agent hands you, you are not likely to be protected if a problem turns up later, because the inspector’s contract is with the seller.
A builder is not the same thing. Settled lists “ask a builder to look at the property” as a separate option and notes that a builder may not provide a comprehensive report.
We agree with that last point, and we are builders. Inspecting a house and writing it up is the inspector’s trade. Pricing and fixing what they find is ours.
What an inspection does not do is just as useful to know. Settled is plain that an inspection may not find all the defects, and suggests you ask the inspector to highlight the areas they could not check and any risk areas that may need further investigation. And a building report tells you what is wrong, not what it costs to fix. That is the gap a price check fills.
Read the “could not inspect” list twice
The parts of the house the inspector could not get to are as important as the defects they found. When we price a report, we list what it could not see alongside the priced items, so you know which numbers are firm and which are open.
every item in the report priced as a low–high range including GST;
each item marked urgent, soon or cosmetic, with the trade it needs;
what the report could not see;
one summary page you can take into the negotiation.
It is priced by a Master Builder with a QS (a quantity surveyor, the person who measures and costs building work) from our own Auckland jobs: 500+ projects since 2014.
It costs $199 including GST with a 2 working day turnaround, or $299 for the next working day. We take one next-working-day order per day, subject to availability. The clock starts when we have received your report and confirmed it.
Be clear on what it is not. It is a desktop study, which means we work from the report and do not visit the house. It is not a building inspection, and it is not a quote. Our guide to estimates, quotes and proposals explains the difference. We are also not an independent valuer or an independent QS. We are a building company pricing work we carry out ourselves, and you should read our numbers with that in mind.
The fee is credited: “If AVR does the work within 12 months, your report fee comes off the contract. It counts only against a signed contract and is never refunded as cash.”
Our team with clients on a finished project. The people who price a report are the same people who build the work.
When a builder’s site visit is worth it
Most buyers do not need one. A site visit earns its fee in three situations.
Your situation
Why a visit helps
The priced list comes to a large sum
When big money rests on a few items, it is worth having a builder look at those items on the house itself.
The report is vague or hedged
Wording like “further investigation recommended” is hard to price from a desk. On site we can see how far the problem is likely to run.
The range on a key item is wide
Seeing access, the size of the area and what the work connects to lets us tighten the range.
The pre-purchase site visit is $449 including GST. We spend up to 1 hour at the house with the report, and you get a written price update within 2 working days. We book it through the real estate agent, since the house is not yours yet, and there is no travel charge anywhere in Auckland.
If you have already paid for one of our reports on the same house, that fee comes off the $449, up to $199. So after a Price Check the visit costs $250. After a $99 cost plan it costs $350.
A site visit is still not a building inspection. We are there to price work, not to inspect the house. If you have no inspector’s report yet, get that first.
Where the free Instant Estimate fits
The Instant Estimate is our free online calculator. You answer a few questions and get a ballpark in minutes. It gives one range for a whole project, such as a bathroom, a kitchen or a full renovation. It does not read your building report and it cannot price a list of defects item by item.
It is most useful early, when you are comparing houses and want to know roughly what the renovation you have in mind would cost. It is the only free pricing step we offer buyers.
A simple order of steps
Step
What to do
Who to talk to
1
While you are looking, use the Instant Estimate for a rough renovation budget
No one. It is online and free
2
Once you are serious about a house, commission your own building inspection
An accredited property inspector
3
Read the report, including the list of what could not be inspected
The inspector, for anything you do not follow
4
Get the items priced
Us, with a Building Report Price Check
5
If the total is large or the report is unclear, book a site visit
Us, through the agent
6
Decide what to do with the number
Your lawyer, for your agreement and its conditions
Step 6 is not ours to advise on. Settled explains that if a satisfactory property inspection report is a condition of your offer and the report is not satisfactory to you, you may be able to withdraw your offer on those grounds. What you can do under your own agreement, and by what date, is a question for your lawyer or conveyancer. For what your lender needs, ask the bank.
If you are planning changes to the house as well as repairs, our cost planning reports cover renovations, recladding and extensions in the same desktop format.
Our team accepting a House of the Year award. We won Regional Gold in 2025 and 2026 and were a Regional Category Winner in 2026.
Other reports you may hear about
LIM (land information memorandum). A LIM is a report the local council prepares at your request. Settled describes it as a summary of the property information the council holds on the day it is produced, such as building consents, drainage, zoning and special land features like flooding. It is about the council’s records, not the condition of the building, and it will not show a problem the council has never been told about. Your lawyer or conveyancer can help you read it.
Weathertightness inspection. Settled says buildings with plaster-style monolithic cladding built between the late 1980s and the mid-2000s carry a high risk of leaking, and that you should get an independent building inspection or a weathertightness expert to look at a house of this type, because there may be no obvious signs. It adds that an inspector can use a moisture meter to indicate moisture problems without making holes in the walls. Any further or invasive testing they recommend is a specialist’s job, not ours.
Engineer’s or surveyor’s report. Settled describes this as similar to a property inspection report but more focused on the whole section and the structure of the property.
No. A Building Report Price Check is a desktop study that puts a price range on each item in a report an inspector has already written. We do not carry out building inspections.
Do I still need a building inspector?
Yes. The inspection finds the problems, and without it there is nothing for us to price. Settled.govt.nz recommends an accredited property inspector and a report that meets NZS 4306:2005.
Can a builder do my building inspection?
You can ask one, but it is not what the government’s guide recommends. Settled notes that a builder may not provide a comprehensive report and tells buyers to check the level of indemnity insurance. We do not offer inspections; our site visit is for pricing a house that already has a report.
What does each one cost?
Our Price Check is $199 including GST, or $299 for the next working day, and the pre-purchase site visit is $449 including GST. The Instant Estimate is free. Building inspectors set their own fees, so ask the inspector for a quote before you book.
Which should I get first?
The building inspection. A price check and a site visit both work from the inspector’s report, so they come after it. The only step you can take before the inspection is the free Instant Estimate, for a rough renovation budget.
Is the site visit fee reduced if I already paid for a report?
Yes. What you paid for any of our reports on the same house comes off the $449, up to $199. After a Price Check the visit is $250, and after a $99 cost plan it is $350.
Do you cover all of Auckland?
Yes. The site visit has no travel charge anywhere in Auckland and is booked through the agent. The Price Check is a desktop study priced from our own Auckland jobs, so nobody needs to visit the house for it.
Got a building report and need the numbers?
A Price Check puts a low–high range on every item in the report your inspector wrote. Two working days, or next working day.
Written by Simon LiuFounder, Add Value Renovations · Registered Master Builder · LBP · House of the Year Gold winner 2025 and 2026Add Value Renovations is an Auckland design-and-build company specialising in kitchen, bathroom, full home, and extension renovations. Master Builder 10-year guarantee, $2M public liability insurance, and a track record of 500+ Auckland renovations since 2014.
Bad Building Report? What to Do Before Your Condition Date (NZ 2026)
By Simon Liu · Founder, Add Value RenovationsRegistered Master Builder · Licensed Building Practitioner · House of the Year Gold winner 2025 and 2026 · 500+ Auckland renovationsUpdated 10 Nov 2026 · 9 min read
Do not decide on the report alone: sort the items into urgent, soon and cosmetic, put a price range on each, then talk to your lawyer about asking for a lower price, more time or cancelling under your building report condition. A report tells you what is wrong. It does not tell you what it costs, and the cost is what you need.
The building report has come back with more in it than you hoped, and the clock is running. This is a builder’s plan for the days you have left. We are not lawyers, so where the next step is a legal one we say so and point you to your lawyer or to settled.govt.nz, the government’s home-buying guide.
A white weatherboard villa behind a picket fence. A published photo used for illustration. It is not a house with a bad report; it is the kind of older Auckland home many buyers are holding a report on.
The short answer
A long report is not the same as a bad house. What matters is which items are serious and what they cost to fix. Work through it in this order.
When
What you do
Who helps
First hour
Find your condition date. Read the summary, the significant defects and the list of what was not inspected.
Your lawyer, for the date
Day 1
Sort every item into urgent, soon or cosmetic. Ring the inspector with your questions.
The inspector
Day 1–2
Put a price range on the list.
A builder
Day 2–3
If the numbers are big or the report is unclear, walk through the house with a builder.
A builder, booked through the agent
Before the date
Choose: negotiate, ask for more time, or cancel.
Your lawyer, then the agent
The days are a guide to the order, not a promise that everything fits your window. If it does not fit, ask your lawyer about more time on day 1, not on the last day.
The first hour: what to read first
Start with your agreement, not the report. Your sale and purchase agreement sets out how many working days you have to fulfil each condition. Settled.govt.nz explains this on its page about the sale and purchase agreement when buying. Ask your lawyer to confirm the exact date your building report condition runs out.
Then read the report in this order:
The summary. The inspector’s overall view of the house.
Significant defects and urgent items. Settled.govt.nz says an accredited inspector’s report should identify any defects and what urgent and long-term maintenance is needed.
Anything about water. Moisture readings, leaks, cladding, roof, gutters, showers. Water is what turns a small repair into a large one.
What was not inspected. Look for the areas the inspector could not get to or could not see, such as a roof space, a subfloor or behind fitted furniture.
Check who ordered the report. If the agent or the vendor gave it to you, settled.govt.nz warns that you are not likely to be protected if you rely on a report you did not commission. See its page on learning about the property.
Day 1: sort the list and ask the inspector
Put every item in the report into one of three groups. It is the same sorting we use when we price a report.
Group
What belongs here
What it means for you
Urgent
Water getting in, anything unsafe, anything getting worse while it waits
This is the money that decides the deal. Price it first.
Soon
Things near the end of their life that still work today
A cost in your first few years of owning the house. Budget for it.
Cosmetic
Worn finishes, marks, things you would change anyway
Rarely a reason to renegotiate. Leave it out of the argument.
Then ring the inspector, who has seen the house, and ask plainly:
Which three items would worry you most if you were buying this house?
Is this item a sign of something bigger, or is it what it looks like?
What could you not see, and would you recommend a specialist look at it?
Write the answers next to the items. The inspector’s job is to find the problems. Putting a cost on them is the next step.
Day 1–2: put a price on it
There are two ways to get a number without anyone visiting the house.
Instant Estimate
Building Report Price Check
Cost
Free
$199 Standard · $299 Next working day
Time
Online, in minutes
2 NZ working days, or the next working day
What you get
One ballpark range for a whole project, such as a bathroom or a kitchen
Every item in your report priced as a low–high range
Best for
A first feel for one big item tonight
The full list, ready to take to your lawyer and the agent
Need the list priced before your date?Every item in your building report as a low–high range, $199.See the Price Check →
Our service prices include GST. The Instant Estimate is the free option. It cannot read your report and it does not price the items one by one.
The Building Report Price Check does. You send us the report and we price every item as a low–high range including GST, mark each one urgent, soon or cosmetic, and name the trade it needs. You also get a note of what the report could not see and one summary page written for the negotiation. It is priced by a Master Builder with a quantity surveyor (the person who measures and costs building work), from our own Auckland jobs.
We take one next-working-day report per NZ day, so that option is subject to availability. On either option the clock starts when we have received your report and confirmed it.
What a Price Check is not
It is a desktop study, done from your report. It is not a quote and it is not a building inspection. We do not do building inspections, and we are not an independent valuer or an independent quantity surveyor.
The fee is not lost if you buy the house and we do the work: “If AVR does the work within 12 months, your report fee comes off the contract. It counts only against a signed contract and is never refunded as cash.”
If the report mentions plaster cladding or moisture in the walls, read our builder’s checklist for buying a plaster home. Cladding is the item that can change the whole decision. Our recladding cost guide explains what drives the price; our Instant Estimate puts a full reclad of most Auckland homes at about $166,000 to $466,000 including GST, and more where a damage report shows widespread framing decay.
Epsom reclad, in progress. One of our own projects with the cladding off and the framing exposed. A building report cannot see inside a wall like this, which is why the “not inspected” list matters.
Day 2–3: see it with a builder
Not every buyer needs this step. It is worth it when the priced list is large or the report is vague about something expensive.
Our pre-purchase site visit is $449 including GST, less what you have already paid for any AVR report on the same house, up to $199. If you paid $199 for a Price Check, that makes it $250. You get up to one hour on site with a builder who has your report in hand, and a written price update within 2 working days. There is no travel charge anywhere in Auckland. The visit is booked through the agent.
Count the days against your condition date before you book. If they do not fit, talk to your lawyer about more time first.
A builder’s visit is still not an invasive test. If the worry is a leaking plaster home, the right next step may be a specialist weathertightness investigation, which our guide to repairing, recladding or selling a plaster home explains.
Using the number: three choices
Settled.govt.nz says that, depending on what an inspection finds, you may be able to use the report to negotiate with the vendor over price or repairs. It also says that if the report is not satisfactory to you, you may be able to withdraw your offer on those grounds. What you can do, and how, depends on the wording of your own agreement. That is your lawyer’s call.
Choice
When it fits
Who you talk to
What to bring
Negotiate
The urgent items add up to real money but you still want the house
Your lawyer first, then the agent, who takes it to the vendor
The summary page with the urgent items and their price ranges
Ask for more time
Something expensive is still unknown and a specialist or a site visit would answer it
Your lawyer, who asks the vendor’s side
What you need to check and how long it will take
Walk away
The cost is more than you can carry, or the unknowns are too large to price
Your lawyer, before the condition date
The report itself
Settled.govt.nz also says the vendor may ask to see a copy of the report, and that if you use its findings to get out of the contract you must give the seller a copy. The vendor may not agree to what you ask. That is why a priced list helps: a range and a trade beside each item is harder to wave away than “the report was bad”.
Start with the urgent group, leave the cosmetic items out, and allow something for what nobody could see. Our article on why renovation budgets blow out explains where the hidden costs in an older house usually come from.
What not to do
Do not rely on a guess. A friend’s “that’s a couple of grand” is not a number you can negotiate with or borrow against.
Do not confirm or waive the condition to keep the deal moving. Once the agreement is unconditional you must complete the purchase. Speak to your lawyer before you give anything up.
Do not let the date arrive without a decision. What happens when a condition date passes depends on your agreement. Ask your lawyer on day 1.
Do not negotiate on every line. A few priced urgent items make a stronger case than a long list of small ones.
When the number is good news
Sometimes the priced list is smaller than the report made it feel. A sound older house can still produce a long report. If the urgent group is short and the rest is ordinary maintenance, the report has done its job.
Then you can go to your lawyer with a clear head and keep the priced list as your maintenance plan. If you are already planning a new kitchen, a bathroom or an extension once you own the house, our cost planning reports cover those.
The Add Value Renovations team accepting a House of the Year award. The people who price your report are the same Registered Master Builder team that builds our projects.
You have the number of working days written into your sale and purchase agreement for that condition. It differs from one agreement to the next. Ask your lawyer to confirm the exact date today, and whether more time is possible.
Can I renegotiate the price after a building report?
You can ask. Settled.govt.nz says you may be able to use a report to help you negotiate with the vendor over price or repairs, but the vendor does not have to agree. Go through your lawyer, and bring priced items.
Can I cancel the agreement because of the building report?
Possibly, depending on the wording of your condition. Settled.govt.nz says that if the report is not satisfactory to you, you may be able to withdraw on those grounds, and that you must give the seller a copy of the report if you do. Your lawyer must handle this, and before the condition date.
Should I get a second building inspection?
Usually not a second general inspection. If the first report raises a specific worry, a specialist for that one thing is more useful, such as an electrician for old wiring, an engineer for structure or a weathertightness investigation for plaster cladding. Ask your inspector which they would recommend.
What does a next-working-day Price Check cost?
$299 including GST, against $199 for the standard 2 working days. We take one next-working-day report per NZ day, so it is subject to availability, and the clock starts when your report is received and confirmed.
Will the vendor fix the problems instead of dropping the price?
They may offer to, and it is one of the things you can negotiate. Think about who would do the work and how you would check it. Ask your lawyer how it should be written into the agreement.
What if I have no building report yet?
Get one first. Settled.govt.nz recommends an accredited property inspector and a report that meets the inspection standard NZS 4306:2005. We do not do building inspections. While you wait, the free Instant Estimate gives you a ballpark for any renovation you already know the house needs.
Report in hand and a date coming up?
Every item in your building report priced as a low–high range, marked urgent, soon or cosmetic. Two working days, or next working day if you are short on time.
Written by Simon LiuFounder, Add Value Renovations · Registered Master Builder · LBP · House of the Year Gold winner 2025 and 2026Add Value Renovations is an Auckland design-and-build company specialising in kitchen, bathroom, full home, and extension renovations. Master Builder 10-year guarantee, $2M public liability insurance, and a track record of 500+ Auckland renovations since 2014.
Can You Live in the House During a Renovation? Stay, Stage or Move Out (2026)
By Simon Liu · Founder, Add Value RenovationsRegistered Master Builder · Licensed Building Practitioner · House of the Year Gold winner 2025 and 2026 · 500+ Auckland renovationsUpdated 10 Nov 2026 · 9 min read
You can usually stay home for one bathroom, a kitchen, or a job kept to one part of the house, but for a full-home renovation moving out is normally the faster choice and often the cheaper one overall. A furnished family rental in Auckland typically runs $3,000–$8,000 a month, and a major build with the family living in it typically takes 20–30% longer on site.
“Can we stay?” came up in 20 of the 69 consultations we reviewed for this guide, and “can we do it in stages?” in 24. One couple put the worry plainly: “If we have to move out, we may as well buy a house that’s ready to go.” This guide sets out when staying works, when it does not, and how to stage a job so you do not pay for the same work twice.
Blockhouse Bay full-home renovation, finished. A published project photo of the living and dining area. When the floors and living spaces of the whole house are being done, there is nowhere left to live around the work.
The short answer, job by job
Three things decide it: whether you still have a working toilet and shower, whether you can cook, and whether the work can be closed off from the rooms you sleep in.
The job
Our usual answer
What the household lives without
One bathroom, and it is the only one
Stay with planning, or move out while it is on site
No shower or bath in the house, and at times no toilet
A second bathroom or ensuite
Stay
One bathroom. Everyone shares the other
Kitchen
Stay with planning
Sink, cooktop, oven and bench space. You cook from a temporary set-up in another room
Kitchen plus bathroom
Stay with planning if another bathroom still works. If not, move out
Cooking and one bathroom at the same time
Full home
Move out. Staging is the alternative
Kitchen, bathrooms, floors and power, room after room
Extension
Stay with planning
Part of the section, then the rooms that join the new part while the two are connected
Working out how your job would run?Talk it through on a free 30-minute phone call.Book a phone consultation →
“Stay with planning” means it works if the temporary arrangements are agreed before the job starts.
When it is your only bathroom
This is the hardest small job to live through. Once the old bathroom is stripped out there is no shower, and the toilet is out of use for at least part of the work.
Most Auckland bathroom renovations take 3–5 weeks on site once the materials are on hand. A tiled shower adds one to two weeks over an acrylic one. Plan to be without the room for the time the job is on site.
What makes it workable:
Have everything on hand first. Tiles, vanity, tapware and shower should be chosen and delivered before strip-out (when the old room is taken back to the framing). Late selections are the most common avoidable hold-up.
Sort out the toilet before day one. Ask your builder how long it will be disconnected and whether a temporary one can be provided.
Line up showers. Family, a neighbour, the gym or the pool.
Think about going away. A holiday or a stay with family is best booked for these weeks.
A separate toilet that is not part of the job makes staying much easier.
Living without a kitchen
Most people stay home through a kitchen renovation. You will be without a working kitchen for a few weeks while the job is on site. How many depends on the size of the job: a cosmetic refresh is far quicker than a kitchen where walls, plumbing or wiring move.
The long wait is before anyone arrives. Custom cabinetry takes four to eight weeks to make once your design is locked in, and your old kitchen can stay in use for that time. Ask for the strip-out date to be tied to the cabinetry delivery date.
Set up a temporary kitchen in another room before the old one comes out:
the fridge, a microwave and a kettle;
somewhere to wash dishes, such as the laundry tub;
the barbecue, if you have one;
a bit more in the food budget for takeaways.
Mt Roskill full-home renovation, 2025. The finished kitchen, from our published project. Custom cabinetry is made off site, so the old kitchen can stay in use while it is built.
Full home: stay, stage or move out
A full-home renovation takes the kitchen, the bathrooms, the floors and the wiring out of use, and it runs for months, not weeks. For a job like that, temporary accommodation is usually necessary to avoid disruption and safety risks. You have three choices.
Stay through it
Stage it
Move out
How it works
The whole job runs around you
The house is split into parts. You live in one while the other is built
The house is handed over empty
Time on site
Typically 20–30% longer than an empty house
Longest overall, because the job is set up and finished more than once
Shortest
What it costs you
No rent, but a longer build
No rent, but usually more in total than one job
Rent, typically $3,000–$8,000 a month for a furnished family home
What it is like
Dust, noise and temporary services every day
Half a house, with a working kitchen and bathroom
A normal life somewhere else, and visits to site
The rent figures are rents, not building prices. They sit outside your building contract, so add them to your budget as a separate line.
Why staying costs more than it looks. Trades work around your family and your day, temporary services have to be kept going, and decisions get made in a hurry because everyone wants it over. That is where the extra time on site comes from. We cover it in why renovation budgets blow out.
Why moving out is often cheaper overall. The rent is a cost you can see, so it feels like the expensive choice, but it is often less than the cost of a slower, occupied build. You are not cut off from the job either: the programme, daily updates and photos stay visible, as described in how we manage your renovation.
“Are you okay if we stay on site, downstairs?” Sometimes, yes. It can work when one level has its own bathroom, somewhere to cook and its own way in, and none of the work passes through it. That is really a staged job, covered next. Our full home renovation guide explains what a whole-house job involves.
Ring your insurer first
Tell your house insurer before the work starts, and before the house is left empty. Ask what cover applies during the work, and get the answer in writing.
Blockhouse Bay, before. The street view of the house before work started. This full-home renovation went on to win Gold at the 2025 Master Builders House of the Year.
Staging without paying twice
Staging means building the job in two or more parts, so you can live in one part of the house or spread the cost. One client asked for exactly the right thing: “two phases without double-paying for any work.”
Staging usually costs more in total than doing everything at once, because the builder sets up and brings each trade back more than once. What you can avoid is the worse cost: paying for work in stage one, then pulling it apart in stage two.
The rule is simple. Design the whole house once, then do the work that runs through the whole house once.
Work
When
Why
Wiring and switchboard
Once, in stage one
Cables run through walls and ceilings across the house. Run the stage-two cables while the linings (the plasterboard) are off
Plumbing and drains
Once, in stage one
Pipes for a later bathroom or kitchen are run and capped off now, so finished floors and walls are not cut open later
Floors
Once, where one floor runs through several rooms
One floor done in one go avoids a join between old and new part-way through the house
Painting, wardrobes, built-in joinery
Can wait, room by room
Nothing else depends on them
Fitting out a later bathroom
Can wait, if its pipes and wiring are already in
The hidden work is done; only the visible part is left
Then set up each stage so finished rooms are not reopened:
Draw the line at a wall or a door, not through the middle of a room, so each stage can be closed off and finished.
Keep a working kitchen and bathroom on your side of the line at every stage.
Plan the trades’ way in. Stage two should not be carried through the rooms finished in stage one.
Have the whole job priced, split by stage, before stage one starts.
We plan the staging around your situation at the design stage. Our week-by-week renovation timeline shows the order the work happens in, which helps when deciding where the line between stages goes.
Children, pets, working from home, dust and asbestos
Children. A building site has open floors, tools and power leads. If you stay, agree before the job starts how the work area will be shut off from small children.
Pets. Doors and gates are open while trades come and go, and some animals are stressed by the noise. Plan somewhere else for pets on the loudest days.
Working from home. Demolition, cutting and nailing are loud and do not stop for video calls. Ask for notice of the heavy days and plan to work elsewhere on them.
Dust. Ask how the work area will be sealed off from the rooms you are living in, how the floors on the way through will be protected, and how the site is left at the end of each day.
Asbestos. Older Auckland homes can have asbestos in linings and floor coverings. If asbestos is found or has to be removed, the affected area is closed off and nobody lives in it until it has been cleared. Allow for that if you are staying in an older house.
Lynfield whole-home renovation. A finished room with a built-in study, from our published project. Built-in joinery like this is one of the items that can wait for a later stage.
Rentals: can tenants stay?
“Can the tenants stay?” is a question landlords ask us. On the building side the answer is the same as for an owner: it depends on whether the house still has a working bathroom and kitchen and whether the work can be closed off.
The tenancy side is not ours to answer. A landlord must talk to the tenant and check their obligations with Tenancy Services before any work starts. Do that first, then book the builder.
For a full-home renovation, often yes. A furnished family rental in Auckland typically costs $3,000–$8,000 a month, but a major build with the family living in it typically takes 20–30% longer on site, which often costs more than the rent saved. For one bathroom or a kitchen, most people stay.
How long will I be without a bathroom?
Plan for the time the job is on site, which is 3–5 weeks for most Auckland bathroom renovations once materials are on hand. A tiled shower adds one to two weeks over an acrylic shower.
How long will I be without a kitchen?
A few weeks, while the job is on site. A cosmetic refresh is much quicker than a kitchen where walls, plumbing or wiring move. Custom cabinetry takes four to eight weeks to make, but your old kitchen stays in use during that time.
Can a renovation be done one room at a time?
Yes, and with two bathrooms it means one is always working. For a whole house it usually costs more in total. Plan the wiring, plumbing and floors for the whole house first, so finished rooms are not reopened.
Does staging a renovation cost more?
Usually, yes. The builder sets up and brings each trade back more than once. Keep the extra down by designing the whole job at the start and doing the wiring, plumbing and floors once.
Will my insurance cover an empty house or a house under renovation?
Only your insurer can tell you that. Tell them before the work starts and before the house is left empty, and ask what cover applies during the work.
Can tenants stay during a renovation?
On the building side it depends on the job: tenants need a working bathroom and kitchen and the work must be closed off from where they live. On the tenancy side, the landlord must talk to the tenant and check their obligations with Tenancy Services before work starts.
Not sure whether to stay or move out?
Tell us about the house and the job on a 30-minute phone call and we will talk through how it could run.
Written by Simon LiuFounder, Add Value Renovations · Registered Master Builder · LBP · House of the Year Gold winner 2025 and 2026Add Value Renovations is an Auckland design-and-build company specialising in kitchen, bathroom, full home, and extension renovations. Master Builder 10-year guarantee, $2M public liability insurance, and a track record of 500+ Auckland renovations since 2014.
Moisture Readings in a Building Report: What They Mean and Repair Costs (2026)
By Simon Liu · Founder, Add Value RenovationsRegistered Master Builder · Licensed Building Practitioner · House of the Year Gold winner 2025 and 2026 · 500+ Auckland renovationsUpdated 10 Nov 2026 · 9 min read
A moisture reading in a building report tells you where water may be getting into a wall, but it does not tell you how much damage is behind the lining or what the repair will cost. Before you go unconditional, find out the cladding type, whether there is a cavity and whether invasive testing is needed, then get a repair cost range for each outcome.
Buyers ring us with the report open in front of them and a condition date a few days away. One put it this way: “The report is very much not clear… could be a problem, might not be.” Another asked: “Report says the cladding is direct-fixed with no cavity. Is that a risk?” This guide explains what the readings can and cannot tell you, what to do in the days you have, and what the repairs cost.
Epsom reclad, 2023. One of our published projects part-way through, with the plaster cladding off and the timber framing exposed. Until a wall is opened like this, nobody can see the framing a moisture meter is trying to read.
The short answer
A “moderate” or “high” reading is a pointer. It says: look harder here. It is not a diagnosis and it is not a price.
One raised reading beside a shower or under one window can be a single leak that is fixed locally.
Raised readings in several places on a plaster-clad house from the late 1980s to the mid-2000s, with no cavity behind the cladding, is the pattern that can end in a reclad (taking the outside cladding off and replacing it).
A normal reading does not clear a wall. Timber that was wet last winter can read dry after a long fine spell.
Please read this first
This is general guidance, not advice on any particular house. We are builders: we price repairs and carry them out. We are not building inspectors or building surveyors, and we do not diagnose a house from a report. You still need your own inspector and your own lawyer.
What the readings mean
There are two kinds of moisture reading, and most pre-purchase reports contain only the first.
Non-invasive reading
Invasive reading
Tool
A capacitance meter, held flat against the wall lining or cladding
A resistance meter, with probes pushed into the timber through small drilled holes
What it reads
A relative signal from whatever sits behind the meter
The moisture content of the timber itself, as a percentage by weight
What upsets it
Metal, thick coatings, rough surfaces, changes in density
Recent weather, timber treatment, damaged probes
What it is good for
Showing where to look further
Confirming whether the framing is wet at that spot
What it cannot tell you
How far any decay has spread, or what the repair will cost
The government’s own guide for assessors, Weathertightness: Guide to the Diagnosis of Leaky Buildings (Department of Building and Housing, May 2011, published on building.govt.nz), says capacitance readings are indicative only because they do not measure actual moisture content. It also says these meters are often ineffective through thick cladding such as EIFS, the polystyrene-backed plaster system. A “normal” scan on that kind of wall proves very little.
This is why the words “moderate” and “high” in a report need a question. Ask the inspector which meter was used, what scale the numbers are on, and what the same meter read on a wall that is known to be dry.
The bands assessors use for probe readings. For invasive readings of timber framing, the same guide sets out three broad bands. They relate mainly to untreated radiata pine, and the guide calls every threshold “indicative and not absolute”.
Timber moisture content (probe reading)
How the guide reads it
Up to 18%
Generally considered too dry to support decay, though it can still point to a problem
18–24%
A warning. A problem exists and the excess moisture should be corrected
24% and above
Readings of 24–30% inside walls are commonly associated with actual damage, often extensive
Source: Appendix II of the guide. These bands apply to probe readings only. Do not hold the number from a non-invasive scan up against them.
Two more points from the guide matter to a buyer. First, readings are compared with a dry “control point” on the same building, such as framing under sheltered eaves, which typically reads 9–14%. Anything above that reference is a reason to look further, even when it is under 18%. Second, low readings can mislead. After long dry weather, timber that has been wet and is decaying can lose much of its moisture and read low.
Three things that decide the risk
The same reading means different things on different houses. These three facts change the picture more than the number does.
1. When it was built. The higher-risk houses were mostly built from the late 1980s to the mid-2000s, many of them with plaster-style monolithic cladding (a smooth, jointless plaster finish). Untreated framing was common in part of that period, and untreated timber that stays wet decays faster.
2. The cladding and whether there is a cavity. A cavity is a drained, ventilated gap behind the cladding that lets water run out and the wall dry. “Direct-fixed” means there is no gap. No cavity does not mean the house is leaking. It means the wall is less forgiving when water does get in. A plaster finish over solid concrete block is a different, usually lower, risk. Our guide on whether to buy a plaster home covers each cladding type.
3. Where the raised readings are. One spot, or many? Under windows, at decks and balconies over rooms, where a roof meets a wall, and along the bottom of walls are the common leak points. Sometimes the cause is not the cladding at all. We have seen plumbing leaks show up as damp on an outside wall. Raised readings in several places on a high-risk house is the pattern to take most seriously. See our recladding warning signs.
What to do in the days you have
Go back to the inspector today. Ask which meter, what scale, what the dry reference reading was, and whether they recommend invasive testing. Ask them to mark every raised reading on a plan of the house.
Get the council property file. It shows the cladding system, the consents and whether a Code Compliance Certificate was issued. It often answers the cavity question without anyone touching the wall.
Ask about invasive testing. A weathertightness surveyor drills small holes at the suspect spots and reads the timber directly. The house belongs to the vendor, so you need their permission first.
Get a cost range for each outcome. Local repair, partial reclad, full reclad.
Talk to your lawyer early. What your conditions allow, and whether more time can be asked for, is legal advice. Get it from your lawyer, not from a builder or an agent.
Illustrative sample, not a real property. A sample page from our Recladding Cost Plan showing the kind of findings read from a council property file.
What repairs cost
These are the figures already published in our recladding cost guide. They are guide ranges, not quotes for your house.
Outcome
When it applies
Published guide range
Local repair
One leak with a clear cause, such as one window or a plumbing leak, and sound framing around it
Priced job by job. We publish no range
Partial reclad
The failure is limited to one wall, one side of the house or a few junctions, and the rest is sound
$40,000–$120,000
Full reclad, smallest case
A small single-storey home under 130 m², in fibre cement, with no framing damage
About $120,000–$135,000
Full reclad, typical
Most Auckland homes, depending on size, storeys and cladding chosen
About GST: our recladding cost guide does not state whether these ranges include GST, so treat them as guide figures and make sure any figure you rely on says which it is. The report and site visit fees further down all include GST.
Three cautions go with the table:
The ranges assume sound framing. The cost guide adds 15–30% where a lot of framing has to be replaced.
Anything quoted below $100,000 for a full reclad is a partial repair or has exclusions. Read what it leaves out.
A partial reclad only works where the rest of the house is sound. A proper investigation tells you whether the failure is local or runs through the whole house.
Illustrative sample, not a real property. The cost summary page of a sample Recladding Cost Plan, with the planning band either side of the main figure.
Ways to get a number from us
There are three ways, from free to a visit on site. All prices include GST.
Option
What you get
Price
Turnaround
Instant Estimate
An online ballpark you work through yourself
Free
Minutes
Recladding Cost Plan, Standard
A written order-of-cost plan built from the council property file and your inspection reports. No site visit
$99
10 calendar days
Recladding Cost Plan, Express
The same report, sooner
$199
5 calendar days
Recladding Cost Plan, Priority
The same report, soonest
$299
2 calendar days
Pre-purchase site visit
Up to 1 hour on site with your report in hand, then a written price update
$449
Written update within 2 working days of the visit
The cost plan clock starts once we have your documents and payment. It is an order of cost, not a fixed price, and it is not an inspection. The site visit price drops by what you have already paid for an Add Value report on the same house, up to $199.
If AVR does the work within 12 months, your report fee comes off the contract. It counts only against a signed contract and is never refunded as cash.
Once you have a range for each outcome, you have three choices.
Negotiate. Put the report, the test results and the cost range in front of the vendor through your lawyer or agent.
Ask for more time. If invasive testing cannot be done before your date, ask your lawyer what your options are. We cannot advise on your agreement.
Walk away. If the vendor will not allow proper testing, the readings are raised in several places, or you could not fund the worst case, walking away is a sound result.
Epsom, 2023, finished. The same published project after the plaster cladding was replaced, here in vertical white weatherboard. See the full Epsom recladding and second-storey project.
There is no single pass mark, because it depends on the kind of meter. For probe readings of timber framing, the government’s leaky building diagnosis guide treats up to 18% as generally too dry to support decay, and says all thresholds are indicative. A non-invasive scan gives a relative number that cannot be compared with that figure.
Does a high moisture reading mean a leaky home?
No, not on its own. A high reading shows where water may be present and where to test further. It can come from one failed junction, a plumbing leak, or a wider cladding failure, and only opening or probing the wall tells you which.
Is invasive testing worth it before buying?
Usually yes, when the house is from a higher-risk period, has no cavity, or has raised readings at windows, decks or the bottom of walls. It is the only test that reads the framing itself.
Can I get a repair cost in a few days?
Yes. Our online Instant Estimate is free and takes minutes. A Recladding Cost Plan takes 2, 5 or 10 calendar days depending on the option, from $99 including GST, starting once we have your documents and payment.
Does direct-fixed cladding always need recladding?
No. Direct-fixed means there is no drainage cavity, so the wall is less forgiving if water gets in. It does not mean water has got in. The build year, the framing treatment and the test results decide whether a reclad is needed.
Will the bank lend on a house with high moisture readings?
That is up to your lender, and we cannot answer for them. Talk to your bank or mortgage broker as soon as you have the report, and ask what they need to see.
Who pays for testing before purchase?
The buyer normally arranges and pays for their own reports and testing. Invasive testing means drilling into a house you do not yet own, so the vendor must agree first. Ask your lawyer or the agent to get that agreement in writing.
Need a repair number before your condition date?
A written cost plan built from your building report and the council property file. Standard in 10 days, or 5 or 2 if you are short on time.
Written by Simon LiuFounder, Add Value Renovations · Registered Master Builder · LBP · House of the Year Gold winner 2025 and 2026Add Value Renovations is an Auckland design-and-build company specialising in kitchen, bathroom, full home, and extension renovations. Master Builder 10-year guarantee, $2M public liability insurance, and a track record of 500+ Auckland renovations since 2014.
Planning an Auckland renovation? Find out where asbestos may be hiding, when removal is needed, WorkSafe requirements, safer alternatives and indicative costs.
Converting a Garage into a Minor Dwelling in Auckland: What Council Requires, What It Costs, and When It’s Worth It (2026)
By Simon Liu · Founder, Add Value RenovationsRegistered Master Builder · Licensed Building Practitioner · 2025 House of the Year Gold winner · 500+ Auckland renovationsUpdated 3 September 2026 · 10 min read
Turning a garage into a legal, self-contained minor dwelling in Auckland adds roughly $20,000–$40,000 of design, engineering and council costs before a single wall gets lined. And the 70m² granny flat exemption that everyone is talking about does not apply to conversions — it is for new detached builds only.
This guide is written for the homeowner who has looked at an empty double garage and thought: that could be a rental. It covers what Auckland Council actually asks for, the fire, structural, insulation, water and power work that sits behind those requests, and the honest arithmetic on whether it pays. It is built from the garage projects we run every year, including the ones where we told the owner to stop.
A garage converted to liveable space. The shell is free. Everything that makes it legal — insulation, moisture control, fire separation, services — is not.
Three projects that all start with “convert the garage”
People use one phrase for three very different jobs, and the difference decides your entire budget. What matters is not how you furnish it. It is whether the finished space is part of your house or a second household unit on the property. The moment you put in a kitchen and let someone live there independently, you have created a second dwelling, and Auckland Council treats it as such.
What you are building
Consent
What it triggers
Office, rumpus or sleepout — for your own family, no kitchen
Building consent
Insulation, moisture, ventilation, light, egress. No fire separation between units. No resource consent. No development contributions.
Bedroom plus bathroom — still part of the main house
Building consent
All of the above, plus drainage, waterproofing and wet-area compliance.
Self-contained minor dwelling — kitchen, bathroom, own entry, rentable
Building consent and resource consent
Fire separation between units, separate services, Watercare, development contributions, engineer reports, planner reports.
Row one and row three are separated by a kitchen bench and about $80,000. That is the single most useful sentence in this article.
What council wants for a minor dwelling
Building consent, always
A garage is non-habitable space. A dwelling is habitable space. That change of use is consented building work whether or not you touch a single structural element. The consent has to show the finished space meets the Building Code clauses a garage was never built to: structure, protection from fire, external moisture and internal moisture, ventilation, natural light, and insulation. “We are just lining it” is not a pathway, and it is the mistake that turns up years later when a solicitor asks for the paperwork.
Resource consent, once there is a kitchen
Under the Auckland Unitary Plan a self-contained unit is a second household unit on the site. Depending on your zone and what is already there, that needs resource consent. The planner will look at site coverage, height to boundary, outdoor living space for both units, and parking — which is awkward, because you have just removed the garage. Most sites allow one minor dwelling as a permitted or restricted discretionary activity; a second one always needs consent. Flood plains, heritage and Special Character overlays add their own layer.
Watercare and development contributions
A new household unit generally means a Watercare connection assessment and, in many cases, a separate connection or meter. It also means development contributions — the council charge for the extra demand a new dwelling puts on roads, parks and stormwater. In most established Auckland suburbs that is in the order of $20,000 plus GST per household unit, and in designated investment priority areas it can be materially higher. It is not negotiable and it is not related to how modest your build is.
The exemption does not cover you
The Building and Construction (Small Stand-alone Dwellings) Amendment Act 2025 took effect on 15 January 2026 and allows a new, detached, single-storey dwelling up to 70m² to be built without building consent, where the work is done or supervised by a Licensed Building Practitioner and council is notified at start and finish. Converting an existing garage sits entirely outside it. Attached, existing, change of use — three reasons it does not qualify. Read the full 70m² exemption guide.
Fire separation — the part nobody budgets for
This is the requirement that surprises people, and it is the one that makes attached garage conversions expensive. Once the converted space is a separate household unit, the Building Code requires a fire separation between it and the rest of the house. In practice that means a fire-rated wall and a fire-rated ceiling, built to a tested system, with every penetration — downlights, pipes, ducts, cables — fire-stopped to match.
The wall is the easy half. The ceiling is where the money goes. The separation has to be continuous, which usually means carrying the rated line up into the roof or floor space above the garage. On a lot of Auckland homes that space is tight: low trusses, existing floor joists, no working room. Fitting fire-rated linings, blocking and additional bearers or framing up there is slow, awkward, hand-cut work, and it often has to happen before anything else can be closed in.
Expect a fire report from a fire engineer as part of the consent set, and expect the specified system to dictate your linings, your framing spacings and your junction details. You cannot value-engineer it on site.
“Owners budget for a kitchen and a bathroom. They do not budget for two people crawling around a 700mm roof space for a week fitting fire-rated linings and bearers they will never see again.”
— Simon Liu, Founder, Add Value Renovations
Structural work and the ceiling-height trap
Removing the garage door and building a proper insulated exterior wall with windows is structural work. The opening is usually carrying load, so you are into lintels, posts and often a producer statement from a structural engineer. If the roof structure is altered to raise a ceiling, that is engineering too.
Then there is the floor. Older Auckland garage slabs generally have no damp-proof membrane under them, and the finished floor of a habitable room has to be dry and insulated. The usual answer is a built-up insulated floor over the existing slab with a moisture barrier, which lifts the finished level by 50–100mm. That matters, because you need adequate clear ceiling height for a habitable room, and many older garages start at 2.2–2.3m. Raise the floor, add a fire-rated ceiling underneath the joists, and you can end up short. Fixing that by lifting the roof is a major structural job and it is where a lot of conversions stop being worth doing.
Measure the existing floor-to-underside-of-joist height before you fall in love with the idea. It is the cheapest feasibility test there is.
The garage door goes, a wall comes in. Structural work: lintels, framing, weathertight junctions and double glazing — not a panel swap.
Insulation, water and power
Insulation. Walls, ceiling and floor all have to meet the current H1 requirements, along with double glazing to the new windows. This is a large part of why a conversion is not a cheap reline.
Moisture. Damp-proofing the slab, weathertightness at the new wall and window junctions, and continuous flashings. Garages leak in ways nobody notices until the space is carpeted.
Wastewater. A bathroom and kitchen need a drainage run to the sewer with adequate fall. Detached and low-set garages frequently do not have it, and a sewage pump system is the fallback — more cost, plus ongoing maintenance.
Water supply. A separate unit may need its own supply and meter through Watercare, and in some parts of Auckland new connections carry capacity constraints.
Power. A garage sub-circuit will not run a dwelling. Expect a new sub-board, and on older homes the main switchboard or even the incoming supply may need upgrading.
Ventilation and heating. Mechanical extraction to the wet areas and a compliant heating source. Required, not optional.
Wet areas are the cost jump. Drainage with adequate fall, waterproofing and extraction — and a pump system where the slab sits below the sewer.
The real cost stack
Split the number in two. There are the costs you incur before you build, and the build itself. For a self-contained minor dwelling conversion, the first pile is the one people underestimate.
Before you build
Typical 2026 range
Design and concept
$4,000–$8,000
Consent documentation and application
$6,000–$10,000
Fire engineer report
$3,000–$6,000
Structural engineer and producer statements
$2,500–$6,000
Council building consent deposit, levies and CCC
$3,000–$6,500
Resource consent deposit and assessment of effects
$6,500–$13,000
Development contributions
from ~$20,000 + GST
Watercare connection and capacity charges
Site specific
Soft costs before construction
$20,000–$40,000+
Then the build. A self-contained single-garage conversion in Auckland generally lands around $110,000–$145,000, and a double garage converted to a two-bedroom unit around $160,000–$220,000. A conversion that stays part of the house — a room, or a room with a bathroom — is a completely different number. Our garage conversion cost guide covers those ranges in detail.
If the only goal is rental income, usually not. Add the soft costs to the build and a self-contained single-garage conversion is a $140,000–$180,000 project that produces a small, low-ceilinged unit with no garden of its own, and it costs you your off-street parking. At $380–$580 a week you are looking at a long payback before maintenance, vacancy and rates, and the resale value of a converted garage is rarely the full sum of what you spent on it.
Now compare it with the alternative. If you have the land, a new detached minor dwelling up to 70m² needs no building consent and no resource consent under the 2026 exemption, provided it is built or supervised by an LBP. You skip the consent processing time, you skip the fire separation between units entirely because it is a standalone building, you get full ceiling height, a proper layout, better glazing, and roughly double the floor area. It rents for more and it appraises for more. Development contributions still apply, but almost everything else in the soft-cost table above goes away.
“If you have got the land, build the minor dwelling. Converting the garage to rent it out is spending minor dwelling money to get a garage.”
— Simon Liu, Founder, Add Value Renovations
The exception is the site with no room — a tight section, a steep back yard, no access for a new build. There, a conversion may be the only way to add a unit at all, and then the maths is about whether the property supports the spend. That is a feasibility conversation, not a guess. See how we build granny flats and minor dwellings.
When a garage conversion does make sense
Very often — just not as a rental. The conversions that pay for themselves are the ones that stay part of your house:
A home office with a door you can close, away from the family.
A sleepout or rumpus for your own family — a teenager who needs their own space, a parent who needs a bedroom on the flat.
An extra bedroom that the market recognises when you sell.
A media room or second living area in a house that only has one.
None of these creates a second household unit. So there is no resource consent, no fire separation between units, no development contributions and no Watercare connection. You still need building consent, and you still need to do the insulation, moisture and ventilation work properly — but the project is a fraction of the cost and the approval path is short. Council is comfortable with these, and so are we. Our step-by-step garage-to-room guide with a full case study walks through one from brief to handover.
Case study: making the downstairs legal in Remuera
Remuera — garage conversion, Certificate of Acceptance, kitchen and bathroom
Location: Remuera | Scope: COA + two bedrooms + new bathroom | Year: 2024
The owners bought a charming Remuera home with a downstairs that had been lived in for years. When they applied for consent to renovate, council told them the area was still officially a garage. Before they could build anything new, they had to legalise what was already there — a Certificate of Acceptance for work done by someone else, years earlier.
We took over the council coordination, the design and the build. The downstairs is now recorded as living space: two proper bedrooms and a full bathroom, all signed off. That is the cost of an unconsented conversion — paid by the next owner, with interest.
Do I need consent to convert my garage into a minor dwelling in Auckland?
Yes — building consent always, and resource consent as well once the unit is self-contained. Converting non-habitable garage space to habitable space is a change of use under the Building Act, so building consent is required even if you do not touch the structure. Adding a kitchen creates a second household unit under the Auckland Unitary Plan, which brings resource consent, Watercare and development contributions into play.
Does the 70m² granny flat exemption cover a garage conversion?
No. The exemption that came into force on 15 January 2026 applies only to new, detached, single-storey dwellings up to 70m² built or supervised by a Licensed Building Practitioner. A garage conversion is existing, usually attached, and involves a change of use — so it needs full building consent regardless of floor area.
Can I rent out a converted garage in New Zealand?
Only if it is consented as a habitable, self-contained unit and meets the Healthy Homes standards. Renting an unconsented conversion risks your insurance on the whole property, exposes you to council enforcement, and creates a disclosure problem the day you sell. If rental income is the goal, price a new detached minor dwelling alongside the conversion before committing.
What fire rating do I need between a converted garage and the house?
Once the space is a separate household unit, the Building Code requires a fire separation between the two units — a rated wall and ceiling built to a tested system, with all penetrations fire-stopped. The rating and the specific system come from the fire report prepared for your consent. On attached garages the ceiling separation usually has to be carried through the roof or floor space above, which is the most labour-intensive part of the job.
Will I have to pay development contributions?
If the project creates an additional household unit, yes. Auckland Council charges development contributions per household equivalent — in the order of $20,000 plus GST in most established suburbs, and higher in designated investment priority areas. The charge is set by policy, not by the size or spec of your build, and it applies to exempt granny flats too.
How long does a garage-to-minor-dwelling project take?
Plan on six to ten months end to end. Design, engineering reports and both consents typically take three to five months, and the build itself runs twelve to sixteen weeks depending on scope and whether the roof space work is straightforward. A conversion that stays part of the house moves considerably faster because there is no resource consent in the path.
Is it cheaper to convert the garage or build a new minor dwelling?
Per square metre of usable space, a new detached minor dwelling under 70m² is usually the better buy in 2026. It avoids building and resource consent, avoids fire separation between units, delivers full ceiling height and roughly double the floor area, and keeps your garage. A conversion wins only where there is no room or no access for a standalone build.
What happens if a garage was converted without consent before I bought the house?
You apply for a Certificate of Acceptance, which is council’s retrospective sign-off on work it did not inspect. It generally means opening up parts of the build so an inspector can see what is behind the linings, and bringing anything non-compliant up to standard. It is worth doing before you list the property, not during the sale.
Not sure which path your site supports?
We assess the conversion and a new minor dwelling side by side, with real numbers, before you spend anything on design.
Written by Simon LiuFounder, Add Value Renovations · Registered Master Builder · LBP · 2025 House of the Year Gold winnerAdd Value Renovations is an Auckland design-and-build company specialising in home extensions, minor dwellings, full home, kitchen and bathroom renovations. Master Builder 10-year guarantee, $2M public liability insurance, and 500+ Auckland renovations since 2014.
A typical Auckland house reclad takes 4-6 months on site plus 2-4 months pre-build. Week-by-week breakdown of what actually happens through a 5-month reclad project.
Not every Auckland plaster home needs recladding. The decision framework AVR uses with homeowners — when to repair, when to reclad, when to sell, with real cost comparisons.
We’ve used Simon and his crew on more than 50 projects over the past couple of years, and they’ve become our go-to team. That’s covered everything from smaller jobs through to high-value projects where there’s no room for error, and every single one has been delivered perfectly. The team is great to deal with, extremely professional on site and easy to communicate with from start to finish. They turn up when they say they will, get the job done properly and leave the site tidy. On top of that, their pricing is very competitive, which is hard to find with this level of quality and reliability. When you’re working on high-value projects, you need a crew you can trust completely, and Simon’s team has been that for us every time. Couldn’t recommend them more highly. If you’re looking for a reliable, professional and well-priced team, give Simon a call.
Posted onGoogle
L
LB Family
Nov 2026
Simon and his team did a professional job. We are still loving our renovated bathroom!
Posted onGoogle
G
Graeme Hepburn
Nov 2026
Thank you to Simon and Add Value renovations for their help with restoring our damaged living room. The work was done to a high standard and in a great timeframe. I am especially grateful to Simon who continued to support us in a fairly limited scope and probably not very lucrative project that had very large delays on our side, as we negotiated insurers etc.
Posted onGoogle
D
Daksha Ben
Nov 2026
Add Value Renovations team was very easy to deal with. Dedication and attention to every detail has transformed the house beautifully. Excellent workmanship.
Posted onGoogle
A
Alan Grace
Nov 2026
Add Value was contracted to do an insurance job at my property some time ago. They did a great job. I have no idea of the price since it was an insurance job. Also when I needed a contractor, Simon provided me with a contact when Add Value was too busy to do the work (it was coming up to Christmas).
Posted onGoogle
K
Katie Hayward
Nov 2026
We engaged Add Value Renovations to remove an internal wall and undertake other remedial work as part of our villa renovation in Epsom. Simon and his team were a pleasure to deal with throughout. Their communication was excellent, the workmanship was of a high standard, and the work represented value for money. We have already recommended Add Value Renovations to several friends considering their own renovations. We also have plans to install French doors in our lounge in a few years and will certainly be returning to Simon and his team. We have no hesitation in recommending Add Value Renovations for their quality workmanship, excellent communication and overall value.
Posted onGoogle
P
Peter Yang
Jun 2026
Excellent renovation services, and I'm very appreciative with their hard work and their effectiveness. I strongly recommend other people to talk with Add Value Renovations ltd for your renovation project, you'll be very happy with their accurate information and their excellent professional renovation services.
Posted onGoogle
J
Jann Singer
Dec 2025
Simon and Joanna of Add Value Renovations planned and completed our en-suite upgrade. We are entirely satisfied with the planning, consulting, excellent workmanship and absolutely first class communication. I have recommended Add Value Renovations to all my friends and will be asking them to do further work for us.
Posted onGoogle
C
Carl Anderson
2025
We loved working with Simon and the team at Add Value Renovations. Add Value’s project manager Tim, and interior designer Joanna, had excellent communication, came up with innovative solutions for our challenging 1930’s bungalow full renovation (kitchen, bathroom, re-wiring and removal of internal walls for indoor outdoor flow), delivered our project ahead of schedule and on budget. The team at Add Value have a very high standard of workmanship and the worksite was kept immaculate at all times. We’d also like to make mention of Add Value’s painter Wayne, who quietly goes about his business in the background and completes his work to a very high standard on both interior and exterior finishes. My wife and I found the entire process stress free and we would love the opportunity to work with the Add Value team again. Thank you Add Value!
Posted onGoogle
R
Rajeev Kishore
2025
Simon working with you and your team was a truly positive experience. Your expertise, combined with your friendly and approachable demeanor, made the entire process stress-free. The finished product is stunning, and we couldn't be happier. We’re incredibly pleased with the results and will not hesitate to recommend your services to others.
Posted onGoogle
K
K Noronha
2024
We have used the services of Add Value Renovations twice over three years, once for bathroom renovations and more recently for our kitchen and deck. The quality of work has always been excellent and any issues that arose were dealt with quickly and professionally. We initially chose this company because we were after a more unique look for our renovations that would require a more out-of-the-box approach to planning and execution. Simon was most willing to accommodate our requests and find alternatives when required. Needless to say we were happy with the results and we approached them again to continue our renovations. The pictures speak for themselves!
Posted onGoogle
C
Colin McLennan
2024
Had the pleasure of using Simon and his team on a garage conversion project. Simon made the planning and building process easy and his team were professional in their approach. It was a project that was on time and budget . Have no problem recommending Add Value Renovations for your next project.
Posted onGoogle
J
Jo Nicoud-Garden
2024
I worked with Simon at Add Value Renovations for the painting and recarpeting of my rental house. As I am based overseas, I was unsure how things would go, but I am absolutely delighted with the quality of the final result. Simon was very proactive in sending me update emails, and in drawing my attention to things I wasn't aware of. He was fully transparent in explaining each item on his quote and worked hard to meet all of my additional random requirements as they came up, including tasks such as installing a washing line and building a shed door. I thoroughly recommend Simon and his team.
Posted onGoogle
G
Geoff Pownall
2024
I would strongly recommend Simon and Add Value Renovations for any work that they might be considered for. Simon was most helpful in explaining the work required, went beyond the call of duty when other parties involved with the work caused his having to make additional attendances and his quote was most reasonable. I would have no hesitation in employing Add Value Renovations on a future occasion.
Posted onGoogle
L
Leah song
2024
Just wanted to take a moment to express my appreciation for the outstanding work you've done! A extra mile you help me solve the ceiling issues, your attention to details and commitment to quality really show in your finshed job. More bright after wall painting, good color for carpet, thanks for making this experience so smooth. Will choose you to work for me definitely next time!
Posted onGoogle
A
Alex Salkeld
2024
Simon and his team recently took care of renovating the bedrooms of our house. We are very happy with the final outcome. Great communication, and very informative about the entire process.
Posted onGoogle
B
Bianca Cornford
2023
As a first time house builder, you can imagine how stressful and nerve wracking the experience was. Thanks to Add Value! It's not easy process, we were lucky to have Simon help us go through everything step by step. He was very patient and professional and we love the result.
Posted onGoogle
A
Andrea McLeod
2023
Simon and his team have completed two pieces of work at my home. The renovation of the main bathroom and the kitchen, this included the design, removal of the old bathroom and kitchen and full project management. Simon is really responsive and his work his of a high quality. Since the renovations I have contacted Simon regarding other small jobs and he has been incredibly responsive and helpful.
Posted onGoogle
J
Janie Qu
2023
Simon renovated my house last year. Simon and his team members are very professional, great at time management. They managed to finish my project on time. The finish project looks great. I will highly recommend Simon and his team at Add Value Renovation to everyone.
Posted onGoogle
S
Suzi M
2023
Simon came onsite to provide advice on an insurance payout straight away, and subsequently provided a detailed quote/SOW that insurance settled on (despite being higher than the inital settlement offer). Simon & his team performed the work to a high standard, on budget and on schedule. All of his team, including any subcontractors, were professional, friendly and respectful of our home and time. Tim, the project manager, kept us very informed of any work plans/timing and was a pleasure to deal with. Joanna offered really helpful advice with any design decisions and both Simon & Tim were always fast to respond & helpful if we had any questions or if we were seeking advice. We were very happy with their service & are already thinking about next projects to engage them for again!
Posted onGoogle
H
hodong hwang
2023
I am writing to provide a strong recommendation for Add Value Renovations based on my exceptional experience working with their team on a recent home renovation project. Throughout the entire process, from start to finish, their team demonstrated a remarkable level of professionalism, expertise, and dedication to delivering outstanding results. From our initial consultation to the final touches of the project, I was thoroughly impressed with Add Value Renovations' commitment to excellence. Their team's knowledge and expertise were evident in the careful planning and execution of each aspect of the renovation. The level of professionalism exhibited by Add Value Renovations throughout the project was truly commendable. They adhered to timelines, kept the workspace organized and tidy, and demonstrated a strong work ethic. It was evident that they took great pride in their craft and were committed to exceeding my expectations. Based on my experience, I wholeheartedly recommend Add Value Renovations for any home renovation project. Their professionalism, expertise, and dedication are unparalleled, and their ability to deliver outstanding results is truly impressive. I am thrilled with the outcome of my renovation and eagerly look forward to working with them again on future projects.
Posted onGoogle
M
Michael Black
2023
Renovation A pleasure to deal Efficient. Good communication throughout project. Helpful. Fantastic job. Good suggestions and goes the extra mile. Works with a great team. Michael
Posted onGoogle
J
James W
2023
Simon and crew were very professional when dealing with a bathroom renovation, reflooring job and various touchup jobs we had.
Posted onGoogle
K
ke jia
2023
It’s great experience to work with Add Value Renovation. Good team! Highly recommended!
Posted onGoogle
J
Jay Kumar
2020
I have known simon for a little over 3 years and he has done many projects for me with precision and care. He is extremely reliable and has excellent work ethic. Over the 3 years I have used Simon's team to undertake small repairs around my home through to bigger projects including fully stripping down and renovating my old tired rental property in Auckland. He designed a beautiful kitchen and a very stylish bathroom for my rental property. Simon manages all aspects of the construction so he makes the entire building and renovating process very stress free!! Best of all. He always tries his level best to get things done on time! He just recently completed installing a beautiful new hardwood deck with a fully automated louvre cover with blinds at my home. I highly recommend Simon and his team at Addvalue renovations. Keep up the excellent work
Posted onGoogle
L
Logan Wong
2020
We engaged Add Value Renovations to initially do a bathroom renovation but later on also had them do some internal home repairs after a storm had caused it. They were very professional and proactive with the project. They adhered very well to the scheduled laid out and their friendly demeanour made it very easy to talk and to them. I would definitely recommend them to my family and friends.
Posted onGoogle
M
Michael Botur Writer
2020
A reliable company led by hard workers. Very dedicated to their craftsmanship. Five stars.
Posted onGoogle
G
Grant Innes
2019
Good communication and willingness to keep help us even though we kept changing our mind. Made sure we were happy with everything and made sure all sub contractors kept to the same standard
Posted onGoogle
G
Gary Swift
2019
Quality workmanship and Simon is a really nice guy. Communicates well.
Posted onGoogle
R
RNGA Awesomelotad
2018
My dealings with Add Value Renovations and Simon specifically have been a breath of fresh air! Would definitely recommend.
